SITCOMTN-052

Provenance#

This document was generated based on the contents of the lsst-dm/milestones repository, version 423f629f, dated 2024-06-07. This corresponds to the status recorded in the project controls system for April 2024. Download the report.csv here.

Summary#

_images/blockschedule.png

Fig. 1 Current block schedule. Download the PDF of this Block Schedule here.#

The SITCOM Subsystem is currently tracking 242 milestones: 1 at Level 1, 2 at Level 2, 90 at Level 3, and 89 at Level 4. 60 have no level defined. Of these, 136 have been completed. Of the incomplete milestones, 55 are late relative to the baseline schedule, while the remainder are scheduled for the future.

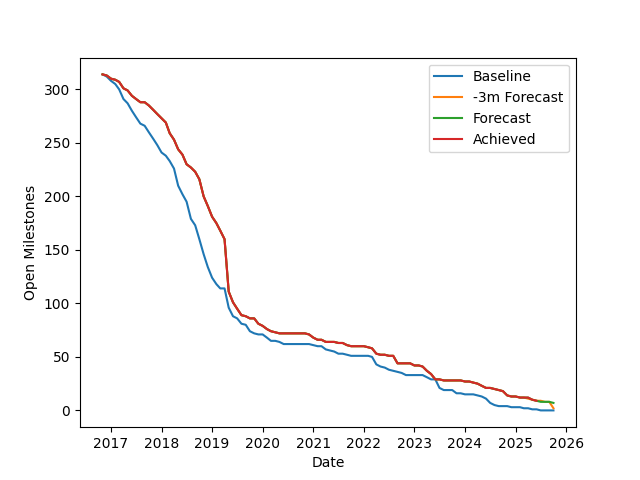

_images/burndown.png

Fig. 2 Milestone completion as a function of date.#

_images/burndownSIT.png

Fig. 3 SIT Milestone completion as a function of date.#

_images/burndownCOM.png

Fig. 4 COM Milestone completion as a function of date.#

_images/burndownSUM.png

Fig. 5 SUM Milestone completion as a function of date.#

Currently overdue milestones#

Overdue SIT milestones

  • SITCOM-124: Camera Arrives at Summit Facility [Due 2023-11-14]

  • SITCOM-101: EAS version 5 installed (main telescope) [Due 2020-01-02]

  • SITCOM-102: TMA safe for transition to M1M3 glass mirror [Due 2023-07-19]

  • SITCOM-104: M2 Glass installed on Cell [Due 2024-04-25]

  • SITCOM-117: EAS fully integrated [Due 2022-03-31]

  • SITCOM-93: EAS Version 3 (construction tracking) ready to start [Due 2019-06-28]

  • SITCOM-95: Level 7th ready to receive the Camera cart Assembly [Due 2022-03-07]

  • SITCOM-96: Computing Infrastructure in Place [Due 2022-05-31]

  • SITCOM-97: M1M3 cell+Surrogate Dynamic Testing on TMA done [Due 2023-08-30]

  • SITCOM-99: M1M3 cell + surrogate installed and verified on the TMA [Due 2023-07-17]

  • SITCOM-105: ComCam + PF re-Installed on TMA [Due 2023-10-06]

  • SITCOM-120: Calibration Pipeline fully implemented [Due 2023-08-18]

  • SITCOM-123: LSSTCam Installed on TMA [Due 2024-05-30]

  • SITCOM-125: LSSTCam reverification complete [Due 2024-04-30]

Overdue COM milestones

Overdue SUM milestones

  • SUMMIT-2976: LSSTCam Received @ Summit [Due 2023-11-06]

  • SUMMIT-2990: COMP: Calibration Telescope Ready for Operations [Due 2023-08-31]

  • SUMMIT-3023: COMP: TMA Refrigeration Tests Complete [Due 2023-12-27]

  • SUMMIT-3055: COMP: L1/L2 recevied at summit [Due 2023-11-06]

  • SUMMIT-3056: COMP: Camera Reverification Complete [Due 2024-04-30]

Milestones by due date#

Due in March 2025#

Due in February 2025#

Due in January 2025#

Due in December 2024#

Due in November 2024#

Due in October 2024#

Due in September 2024#

  • COMC-0240: Begin Full system Integration

  • SITCOM-111: In-Dome Calibration Hardware Ready for On-Sky Operations

Due in August 2024#

Due in July 2024#

Due in June 2024#

Due in May 2024#

Due in April 2024#

Due in March 2024#

Due in February 2024#

Due in January 2024#

Due in December 2023#

Due in November 2023#

Due in October 2023#

Due in September 2023#

Due in August 2023#

  • COMC-2264: Calibration Telescope Ready for Operations

  • COMC-3020: Pathfinder Testing starts

  • SITCOM-97: M1M3 cell+Surrogate Dynamic Testing on TMA done

  • SUMMIT-2990: COMP: Calibration Telescope Ready for Operations

  • SITCOM-120: Calibration Pipeline fully implemented

  • SITCOM-118: AuxTel ready for on-sky characterisation

Due in July 2023#

  • SITCOM-92: Camera support asmy w/ComCam+PF+Int#1+CCW Installed on Telescope

  • SITCOM-102: TMA safe for transition to M1M3 glass mirror

  • SITCOM-99: M1M3 cell + surrogate installed and verified on the TMA

  • COMC-060200-20800: Telescope 3-Mirror Testing Starts

  • SUMMIT-3013: NEED: Pathfinder in ComCam on TMA

Due in June 2023#

  • COMC-3050: TMA Final Testing Complete

  • SITCOM-106: Initial integrated tests on TMA complete

  • SITCOM-98: T&S Milestone: TMA Contract Complete

Due in May 2023#

Due in April 2023#

  • SITCOM-108: Level-3 is ready for the M1M3 surrogate to glass transition

  • SITCOM-100: M1M3 cell + Surrogate ready for installation on the TMA

Due in March 2023#

  • No milestones due.

Due in February 2023#

  • No milestones due.

Due in January 2023#

  • No milestones due.

Due in December 2022#

  • No milestones due.

Due in November 2022#

  • No milestones due.

Due in October 2022#

  • No milestones due.

Due in September 2022#

  • No milestones due.

Due in August 2022#

  • No milestones due.

Due in July 2022#

  • SITCOM-94: Level 3 System Spread integrations activities done

  • SUMMIT-2983: COMP: ComCam re-Verification Complete

Due in June 2022#

Due in May 2022#

  • COMC-060200-20965: Early System AI&T Complete

  • SITCOM-96: Computing Infrastructure in Place

  • SITCOM-112: Commissioning Compute Cluster fully configured and ready for general SIT-Com use

Due in April 2022#

  • No milestones due.

Due in March 2022#

  • SITCOM-117: EAS fully integrated

  • SITCOM-95: Level 7th ready to receive the Camera cart Assembly

Due in February 2022#

Due in January 2022#

  • No milestones due.

Due in December 2021#

  • SITCOM-90: ComCam + PF ready for on cart installation

Due in November 2021#

  • No milestones due.

Due in October 2021#

Due in September 2021#

Due in August 2021#

  • SITCOM-91: Camera cart is fully assembled and tested

Due in July 2021#

  • No milestones due.

Due in June 2021#

  • No milestones due.

Due in May 2021#

  • No milestones due.

Due in April 2021#

  • No milestones due.

Due in March 2021#

  • COMC-2864: ComCam Ready for Onsite Systems Test

Due in February 2021#

  • No milestones due.

Due in January 2021#

  • No milestones due.

Due in December 2020#

Due in November 2020#

  • No milestones due.

Due in October 2020#

  • No milestones due.

Due in September 2020#

  • No milestones due.

Due in August 2020#

Due in July 2020#

Due in June 2020#

  • COMC-060200-20920: TMA Ready to Start Early System AI&T

  • SITCOM-89: ComCam + PathFinder installed on the cart Assembly at Level 3

Due in May 2020#

Due in April 2020#

Due in March 2020#

Due in February 2020#

  • COMC-1164: Commissioning Data Processing Cluster Ready for ComCam Use

Due in January 2020#

Due in December 2019#

  • No milestones due.

Due in November 2019#

Due in October 2019#

Due in September 2019#

Due in August 2019#

Due in July 2019#

Due in June 2019#

Due in May 2019#

Due in April 2019#

Due in March 2019#

Due in February 2019#

Due in January 2019#

Due in December 2018#

Due in November 2018#

Due in October 2018#

Due in September 2018#

Due in August 2018#

Due in July 2018#

Due in June 2018#

Due in May 2018#

Due in April 2018#

Due in March 2018#

Due in February 2018#

Due in January 2018#

Due in December 2017#

Due in November 2017#

Due in October 2017#

  • No milestones due.

Due in September 2017#

  • No milestones due.

Due in August 2017#

  • No milestones due.

Due in July 2017#

  • No milestones due.

Due in June 2017#

Due in May 2017#

  • No milestones due.

Due in April 2017#

Due in March 2017#

  • No milestones due.

Due in February 2017#

  • No milestones due.

Due in January 2017#

Due in December 2016#

  • No milestones due.

Due in November 2016#

Due in October 2016#

  • No milestones due.

Due in September 2016#

  • No milestones due.

Due in August 2016#

  • No milestones due.

Due in July 2016#

  • No milestones due.

Due in June 2016#

Due in May 2016#

  • No milestones due.

Due in April 2016#

  • No milestones due.

Due in March 2016#

  • No milestones due.

Due in February 2016#

  • No milestones due.

Due in January 2016#

  • No milestones due.

Due in December 2015#

  • No milestones due.

Due in November 2015#

  • No milestones due.

Due in October 2015#

  • No milestones due.

Due in September 2015#

  • COMC-2330: LSE-76 Infrastructure between Summit Fac. & DM - Phase 3, T&S Milestone

  • COMC-1110: LSE-132 Infrastructure between Summit Fac. & OCS - Phase 3, T&S Milestone

Due in August 2015#

  • No milestones due.

Due in July 2015#

  • No milestones due.

Due in June 2015#

  • COMC-2310: LSE-76 Infrastructure between Summit Fac. & DM - Phase 3, DM Milestone

Due in May 2015#

  • No milestones due.

Due in April 2015#

  • No milestones due.

Due in March 2015#

  • No milestones due.

Due in February 2015#

  • No milestones due.

Due in January 2015#

  • COMC-1205: LSE-140 Aux Instrum ICD between DM & T&S, Phase 3, DM Milestone

Milestones by WBS#

06C.00: SITCOM Management Level 2 Milestones#

_images/graph_06C.00.png

Fig. 6 Relationships between milestones in WBS 06C.00 and their immediate predecessors and successors. Ellipses correspond to milestones within this WBS element; rectangles to those in other elements. Blue milestones have been completed; orange milestones are overdue.#

COMC-1205: LSE-140 Aux Instrum ICD between DM & T&S, Phase 3, DM Milestone#

  • Level: 3

  • Due: 2015-01-13

  • Completed: 2019-07-31

Warning

No description available

COMC-2310: LSE-76 Infrastructure between Summit Fac. & DM - Phase 3, DM Milestone#

  • Level: 3

  • Due: 2015-06-02

  • Completed: 2019-07-31

Warning

No description available

COMC-2330: LSE-76 Infrastructure between Summit Fac. & DM - Phase 3, T&S Milestone#

  • Level: 3

  • Due: 2015-09-02

  • Completed: 2017-09-30

Warning

No description available

COMC-1110: LSE-132 Infrastructure between Summit Fac. & OCS - Phase 3, T&S Milestone#

  • Level: 3

  • Due: 2015-09-02

  • Completed: 2019-04-15

Warning

No description available

COMC-0620-0100: Start Dome Testing at Vendor#

  • Level: 3

  • Due: 2016-06-06

  • Completed: 2016-06-06

Warning

No description available

COMC-0620-0400: Start TMA Test at Vendor#

  • Level: 3

  • Due: 2016-11-01

  • Completed: 2016-11-01

Warning

No description available

COMC-0620-0200: Start Rotator/Hexapod Testing at Vendor#

  • Level: 3

  • Due: 2017-06-28

  • Completed: 2017-06-28

Warning

No description available

COMC-0620-0700: Start Summit Facility Inspection#

  • Level: 3

  • Due: 2018-02-28

  • Completed: 2018-02-28

Warning

No description available

COMC-0620-0600: Start Coating System testing at Vendor#

  • Level: 3

  • Due: 2018-06-11

  • Completed: 2018-06-11

Warning

No description available

COMC-0620-0300: Start M2+Cell Integrated Optical Tests#

  • Level: 3

  • Due: 2018-10-01

  • Completed: 2018-10-01

Warning

No description available

COMC-0620-0500: Start M1M3+Cell Integration at SOML#

  • Level: 3

  • Due: 2018-11-15

  • Completed: 2018-11-15

Warning

No description available

COMC-0620-3400: Start L3 Assembly Test#

  • Level: 3

  • Due: 2019-03-11

  • Completed: 2019-03-11

Warning

No description available

COMC-0364: ComCam Dewar Assmebly Ready for Integration#

  • Level: 3

  • Due: 2019-04-09

  • Completed: 2019-06-01

Warning

No description available

COMC-0620-3000: Start Filter Mechanism Testing#

  • Level: 3

  • Due: 2019-04-12

  • Completed: 2019-04-12

Warning

No description available

COMC-0620-3700: Start Shutter Testing#

  • Level: 3

  • Due: 2019-04-19

  • Completed: 2019-04-19

Warning

No description available

COMC-2364: Coating Facility Ready for Operations#

  • Level: 3

  • Due: 2019-04-24

  • Completed: 2019-06-03

Warning

No description available

COMC-0620-4100: Start Integrated Cryostat Testing#

  • Level: 3

  • Due: 2019-05-01

  • Completed: 2019-05-01

Warning

No description available

COMC-0620-2000: Start Base Facility Inspection#

  • Level: 3

  • Due: 2019-05-03

  • Completed: 2019-05-03

Warning

No description available

COMC-0021: Mountain-Base Network Verified#

  • Level: 3

  • Due: 2019-05-10

  • Completed: 2019-05-10

Warning

No description available

COMC-0620-0900: Start Mirror Coating & Integration#

  • Level: 3

  • Due: 2019-06-03

  • Completed: 2019-06-03

Warning

No description available

COMC-0620-4400: Start L1L2 Testing & Verification#

  • Level: 3

  • Due: 2019-06-12

  • Completed: 2019-06-12

Warning

No description available

COMC-2464: ComCam Ready for Verification in Tucson#

  • Level: 3

  • Due: 2019-07-01

  • Completed: 2019-07-01

Warning

No description available

COMC-0564: ComCam Ready for System Tests#

  • Level: 3

  • Due: 2019-07-18

  • Completed: 2019-07-31

Warning

No description available

COMC-1164: Commissioning Data Processing Cluster Ready for ComCam Use#

  • Level: 3

  • Due: 2020-02-28

  • Completed: 2020-02-28

Warning

No description available

A5860: Start of Tucson Integration Tests w/ComCam#

  • Level: 4

  • Due: 2020-03-31

  • Completed: 2020-03-31

Warning

No description available

COMC-0964: Start ComCam Integration on Summit#

  • Level: 3

  • Due: 2020-05-13

  • Completed: 2021-03-31

Warning

No description available

COMC-1564: DMS Base Center Complete#

  • Level: 3

  • Due: 2020-05-13

  • Completed: 2020-02-28

Warning

No description available

COMC-0028: Base - Archive Network Verified#

  • Level: 3

  • Due: 2020-12-29

  • Completed: 2023-09-20

Warning

No description available

COMC-2864: ComCam Ready for Onsite Systems Test#

  • Level: 3

  • Due: 2021-03-31

  • Completed: 2021-03-31

Warning

No description available

COMC-0030: Start Early Integration and Test#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-0864: Telescope Top End Interface Ready for ComCam Integration#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-1064: ComCam Ready at Summit#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-1464: Start Photometric Calibration Tests#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-0620-0800: Start In-Situ TMA Testing#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-3050: TMA Final Testing Complete#

  • Level: Undefined

  • Due: 2023-06-19

  • Completed: 2024-04-25

Warning

No description available

COMC-3020: Pathfinder Testing starts#

  • Level: Undefined

  • Due: 2023-08-11

  • Completed: 2024-02-19

Warning

No description available

COMC-2264: Calibration Telescope Ready for Operations#

  • Level: 3

  • Due: 2023-08-31

  • Completion pending

Warning

No description available

COMC-3080: LSSTCam Pack and Transport#

  • Level: Undefined

  • Due: 2023-09-06

  • Completion pending

Warning

No description available

COMC-0005: Pre-Ship Camera Accepted#

  • Level: 3

  • Due: 2023-10-20

  • Completed: 2024-04-10

Warning

No description available

SITCOM-124: Camera Arrives at Summit Facility#

  • Level: 4

  • Due: 2023-11-14

  • Completion pending

Warning

No description available

COMC-0120: Camera Arrives at Summit Facility#

  • Level: Undefined

  • Due: 2023-11-14

  • Completion pending

Warning

No description available

COMC-3000: TMA Final Testing Begins#

  • Level: Undefined

  • Due: 2024-01-03

  • Completed: 2024-02-08

Warning

No description available

COMC-3010: M1M3 Lift Test#

  • Level: Undefined

  • Due: 2024-01-08

  • Completed: 2024-02-02

Warning

No description available

COMC-3030: M1M3 Glass Lift Prep#

  • Level: Undefined

  • Due: 2024-01-24

  • Completed: 2024-02-16

Warning

No description available

COMC-3170: LSSTCam Reverification Start#

  • Level: Undefined

  • Due: 2024-02-08

  • Completion pending

Warning

No description available

COMC-3040: M1M3 Glass Installed#

  • Level: Undefined

  • Due: 2024-02-13

  • Completed: 2024-03-20

Warning

No description available

COMC-3220: LSSTCam L3 Checkout Done#

  • Level: Undefined

  • Due: 2024-02-22

  • Completion pending

Warning

No description available

COMC-3070: ComCam Removed from TMA#

  • Level: Undefined

  • Due: 2024-03-04

  • Completion pending

Warning

No description available

COMC-3060: M1M3 Coating Begins#

  • Level: Undefined

  • Due: 2024-03-11

  • Completed: 2024-04-29

Warning

No description available

COMC-3090: LSSTCam Arrival Allowed#

  • Level: Undefined

  • Due: 2024-03-12

  • Completed: 2024-04-29

Warning

No description available

COMC-0620-2150: Start Summit Commissioning Cluster Test & Verification#

  • Level: 3

  • Due: 2024-04-15

  • Completed: 2024-04-15

Warning

No description available

COMC-3110: M2 Cell Removed from TMA#

  • Level: Undefined

  • Due: 2024-04-16

  • Completion pending

Warning

No description available

COMC-3120: M2 Glass Installed#

  • Level: Undefined

  • Due: 2024-04-25

  • Completion pending

Warning

No description available

COMC-0130: Camera Ready for System Integration#

  • Level: 3

  • Due: 2024-04-30

  • Completion pending

Warning

No description available

COMC-3200: LSSTCam Reverification End#

  • Level: Undefined

  • Due: 2024-04-30

  • Completion pending

Warning

No description available

COMC-3210: LSSTCam on Top End Assembly#

  • Level: Undefined

  • Due: 2024-05-14

  • Completion pending

Warning

No description available

COMC-3130: M2 Glass on TMA#

  • Level: Undefined

  • Due: 2024-05-21

  • Completion pending

Warning

No description available

COMC-3230: LSSTCam on TMA#

  • Level: Undefined

  • Due: 2024-05-30

  • Completion pending

Warning

No description available

COMC-3240: TMA Aligned#

  • Level: Undefined

  • Due: 2024-06-06

  • Completion pending

Warning

No description available

COMC-3150: M1M3 Glass on TMA#

  • Level: Undefined

  • Due: 2024-06-12

  • Completion pending

Warning

No description available

COMC-3140: ComCam Installed on TMA#

  • Level: Undefined

  • Due: 2024-07-12

  • Completion pending

Warning

No description available

COMC-3160: ComCam First Photon#

  • Level: Undefined

  • Due: 2024-07-15

  • Completion pending

Warning

No description available

COMC-3250: Rubin First Photon#

  • Level: Undefined

  • Due: 2024-07-24

  • Completion pending

Warning

No description available

COMC-3260: TMA Pointing Models Complete#

  • Level: Undefined

  • Due: 2024-08-23

  • Completion pending

Warning

No description available

COMC-0240: Begin Full system Integration#

  • Level: 3

  • Due: 2024-09-26

  • Completion pending

Warning

No description available

COMC-3180: ComCam off Sky#

  • Level: Undefined

  • Due: 2024-10-25

  • Completion pending

Warning

No description available

COMC-3190: ComCam off TMA#

  • Level: Undefined

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

COMC-3270: TMA AOS Ready#

  • Level: Undefined

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

COMC-0010: Camera In-Situ Calibration Begins#

  • Level: 3

  • Due: 2024-11-15

  • Completion pending

Warning

No description available

COMC-0020: On-Sky Testing Begins w/Science Camera#

  • Level: 3

  • Due: 2024-12-06

  • Completion pending

Warning

No description available

COMC-1664: DMS Archive Center Complete at SLAC#

  • Level: 3

  • Due: 2024-12-09

  • Completion pending

Warning

No description available

COMC-3280: Rubin First Light#

  • Level: Undefined

  • Due: 2024-12-09

  • Completion pending

Warning

No description available

COMC-3290: Rubin SV1 Start#

  • Level: Undefined

  • Due: 2025-01-31

  • Completion pending

Warning

No description available

COMC-3300: Rubin SV2 Start#

  • Level: Undefined

  • Due: 2025-01-31

  • Completion pending

Warning

No description available

COMC-3310: Rubin Eng Prep for OPS Start#

  • Level: Undefined

  • Due: 2025-02-27

  • Completion pending

Warning

No description available

COMC-2164: Commissioning Complete#

  • Level: 3

  • Due: 2025-03-06

  • Completion pending

Warning

No description available

COMC-3320: Rubin Operations Readiness Review#

  • Level: Undefined

  • Due: 2025-03-06

  • Completion pending

Warning

No description available

COMC-0140: Start SV Data Collection#

  • Level: 3

  • Due: 2025-03-31

  • Completion pending

Warning

No description available

06C.02: Commissioning#

_images/graph_06C.02.png

Fig. 7 Relationships between milestones in WBS 06C.02 and their immediate predecessors and successors. Ellipses correspond to milestones within this WBS element; rectangles to those in other elements. Blue milestones have been completed; orange milestones are overdue.#

COMC-06020200-0500: Commissioning PDR Complete#

  • Level: 4

  • Due: 2017-01-27

  • Completed: 2017-01-27

Warning

No description available

COMC-06020200-0700: Commissioning Baseline Accepted#

  • Level: 4

  • Due: 2017-04-14

  • Completed: 2017-12-01

Warning

No description available

COMC-06020201-1200: MIE: NEED: Shutter at SLAC#

  • Level: Undefined

  • Due: 2017-06-10

  • Completed: 2017-06-10

Warning

No description available

COMC-0620-0740: Summit Facility Inspection Complete#

  • Level: 3

  • Due: 2017-11-13

  • Completed: 2019-01-01

Warning

No description available

COMC-0620-0440: TMA Pre-Ship Acceptance#

  • Level: 3

  • Due: 2017-12-01

  • Completed: 2018-11-19

Warning

No description available

COMC-0620-3300: 1st Production Science Raft Acceptance#

  • Level: 3

  • Due: 2018-01-12

  • Completed: 2017-05-26

Warning

No description available

COMC-0620-0240: Rotator/Hexapopd Pre-Ship Acceptance#

  • Level: 3

  • Due: 2018-02-21

  • Completed: 2019-01-01

Warning

No description available

COMC-06020201-3100: COMP: C_TCR - 2018 Technical Commissioning Review#

  • Level: 3

  • Due: 2018-03-05

  • Completed: 2018-02-01

Warning

No description available

COMC-0620-2050: MTN-Base Network Full BW (2 x 100 Gbps)#

  • Level: 3

  • Due: 2018-03-27

  • Completed: 2018-04-02

Warning

No description available

COMC-060200-20000: Summit Network Available#

  • Level: 4

  • Due: 2018-04-12

  • Completed: 2018-10-01

Warning

No description available

COMC-060203-30008: COMP: C_CDR - Pathfinder#

  • Level: 4

  • Due: 2018-04-19

  • Completed: 2018-01-18

Warning

No description available

COMC-06020201-3180: COMP: C_CR - 2018 Commissioning Review#

  • Level: 3

  • Due: 2018-05-07

  • Completed: 2018-07-31

Warning

No description available

COMC-0620-0340: M2 Pre-Ship Acceptance#

  • Level: 3

  • Due: 2018-05-11

  • Completed: 2018-10-31

Warning

No description available

COMC-060200-20010: Summit Facility Computer Room Available#

  • Level: 4

  • Due: 2018-06-07

  • Completed: 2018-10-01

Warning

No description available

COMC-0464: ComCam Optics & Filters Ready for Integration in tucson#

  • Level: 1

  • Due: 2018-07-09

  • Completed: 2019-02-01

Warning

No description available

COMC-060203-30018: COMP: C_PDR - Pathfinder#

  • Level: 4

  • Due: 2018-07-30

  • Completed: 2018-07-31

Warning

No description available

COMC-060200-20025: Engineering Facility Database Functional#

  • Level: 4

  • Due: 2018-08-06

  • Completed: 2018-11-04

Warning

No description available

COMC-0620-0640: Coating Chamber Pre-Ship Acceptance#

  • Level: 3

  • Due: 2018-08-13

  • Completed: 2018-08-14

Warning

No description available

COMC-060200-20020: Summit Control Room Available#

  • Level: 4

  • Due: 2018-08-20

  • Completed: 2018-10-01

Warning

No description available

COMC-0620-2070: Base Infrastructure Pre-Ship Acceptance#

  • Level: 3

  • Due: 2018-09-26

  • Completed: 2018-04-11

Warning

No description available

SIM-M1: UW Sims FY18 Year End#

  • Level: 4

  • Due: 2018-09-28

  • Completed: 2018-10-01

Warning

No description available

COMC-06020201-2200: MIE: PSR ComCam deliverables#

  • Level: Undefined

  • Due: 2018-10-01

  • Completed: 2019-05-31

Warning

No description available

COMC-060200-20710: OCS Available on Summit#

  • Level: 4

  • Due: 2018-10-12

  • Completed: 2019-11-09

Warning

No description available

COMC-060200-20510: ComCam Dewar Ready for AI&T in Tucson#

  • Level: 4

  • Due: 2018-10-17

  • Completed: 2019-06-30

Warning

No description available

COMC-060203-30028: COMP: C_FDR - Pathfinder#

  • Level: 4

  • Due: 2018-11-07

  • Completed: 2018-10-26

Warning

No description available

COMC-0620-4000: Corner Rafts Pre-Ship Acceptance#

  • Level: 3

  • Due: 2018-11-20

  • Completed: 2019-07-31

Warning

No description available

COMC-0620-4300: Cryostat+FPA Pre-Integration Acceptance#

  • Level: 3

  • Due: 2018-11-20

  • Completed: 2023-05-31

Warning

No description available

COMC-060200-20520: Base Facility Data Center Building + Utilities Ready#

  • Level: 4

  • Due: 2018-11-23

  • Completed: 2020-12-31

Warning

No description available

COMC-0620-2040: Base Facility Inspection Complete#

  • Level: 3

  • Due: 2018-11-23

  • Completed: 2018-11-05

Warning

No description available

COMC-060200-20100: Camera Facility Fiber Optic Lines Ready#

  • Level: 4

  • Due: 2018-11-28

  • Completed: 2021-10-29

Warning

No description available

COMC-060202-50200: COMP: C_PDR - Transport Container#

  • Level: Undefined

  • Due: 2018-12-17

  • Completed: 2019-03-07

Warning

No description available

COMC-0620-4700: Full Filter Complement Acceptance#

  • Level: 3

  • Due: 2019-01-09

  • Completed: 2022-01-31

Warning

No description available

COMC-0620-3200: Filter Mechanism Pre-Ship Acceptance#

  • Level: 3

  • Due: 2019-01-31

  • Completed: 2019-09-30

Warning

No description available

SUMMIT-2992: AVAIL: Refrigeration Pathfinder to ship#

  • Level: 4

  • Due: 2019-02-19

  • Completed: 2020-01-31

Warning

No description available

COMC-0620-3600: L3 Pre-Ship Acceptance#

  • Level: 3

  • Due: 2019-03-22

  • Completed: 2019-10-18

Warning

No description available

COMC-0620-4600: L1L2 Pre-Ship Acceptance#

  • Level: 3

  • Due: 2019-03-22

  • Completed: 2019-09-16

Warning

No description available

COMC-0620-0540: TS M1M3 Pre-Ship Acceptance#

  • Level: 3

  • Due: 2019-04-05

  • Completed: 2019-04-03

Warning

No description available

COMC-060200-20505: ComCam Dewar & Imaging System Ready for AI&T at Slac#

  • Level: 4

  • Due: 2019-04-09

  • Completed: 2019-05-31

Warning

No description available

COMC-060200-20400: Camera Staging Area Utilities Ready#

  • Level: 4

  • Due: 2019-05-01

  • Completed: 2019-05-01

Warning

No description available

COMC-060200-20200: Camera Facility Refrigeration Lines Ready#

  • Level: 4

  • Due: 2019-05-07

  • Completed: 2023-05-31

Warning

No description available

COMC-060200-20050: Summit Facility Camera Utility Room Ready#

  • Level: 4

  • Due: 2019-05-08

  • Completed: 2019-05-08

Warning

No description available

COMC-060200-20500: Summit Facility Clean Room Ready#

  • Level: 4

  • Due: 2019-05-09

  • Completed: 2019-05-08

Warning

No description available

COMC-060200-20300: Summit Facility White Room ready#

  • Level: 4

  • Due: 2019-05-09

  • Completed: 2019-05-08

Warning

No description available

COMC-06020201-1000: MIE: NEED: Filter Changer in Tucson#

  • Level: Undefined

  • Due: 2019-06-01

  • Completed: 2019-06-01

Warning

No description available

SITCOM-93: EAS Version 3 (construction tracking) ready to start#

  • Level: 4

  • Due: 2019-06-28

  • Completion pending

Warning

No description available

SUMMIT-2994: NEED: MIE Chile (TMA) Compressors#

  • Level: 3

  • Due: 2019-07-09

  • Completed: 2020-01-31

Warning

No description available

COMC-0620-3900: Shutter Pre-Integration Acceptance#

  • Level: 3

  • Due: 2019-07-18

  • Completed: 2020-02-21

Warning

No description available

COMC-060200-20030: Dome Installation Substantial Completion#

  • Level: 4

  • Due: 2019-08-22

  • Completed: 2019-11-19

Warning

No description available

COMC-060202-50450: COMP: C_FDR - Transport Container#

  • Level: Undefined

  • Due: 2019-09-05

  • Completed: 2023-12-01

Warning

No description available

COMC-060202-21110: Camera Hexapod/Rotator Ready for Integration#

  • Level: 4

  • Due: 2019-09-27

  • Completed: 2019-07-31

Warning

No description available

SIM-M2: UW Team FY19 Year End#

  • Level: 4

  • Due: 2019-09-30

  • Completed: 2019-09-30

Warning

No description available

COMC-060200-20810: Camera Cart1 + Integrator1 + CCW ready for ComCam#

  • Level: 4

  • Due: 2019-10-28

  • Completed: 2019-11-22

Warning

No description available

COMC-06020200-1100: Commissioning Readiness Review Complete#

  • Level: 4

  • Due: 2019-11-07

  • Completed: 2023-05-31

Warning

No description available

SUMMIT-2993: NEED: Refrigeration Pathfinder on summit#

  • Level: 4

  • Due: 2019-11-26

  • Completed: 2020-09-30

Warning

No description available

SITCOM-101: EAS version 5 installed (main telescope)#

  • Level: 4

  • Due: 2020-01-02

  • Completion pending

Warning

No description available

COMC-060200-20780: Auxiliary Telescope + Spectrograph Ready#

  • Level: 4

  • Due: 2020-01-21

  • Completed: 2019-04-12

Warning

No description available

SUMMIT-3008: AVAIL: White Room Refrigeration System Ready for LSSTCam#

  • Level: 3

  • Due: 2020-03-25

  • Completed: 2022-03-04

Warning

No description available

SUMMIT-3009: AVAIL: Pathfinder for ComCam#

  • Level: 3

  • Due: 2020-03-25

  • Completed: 2020-11-30

Warning

No description available

COMC-060202-50750: COMP: C_FDR - Transport Container#

  • Level: Undefined

  • Due: 2020-03-30

  • Completed: 2023-02-01

Warning

No description available

COMC-060200-10000: Start of On-Sky Data from Auxiliary Telescope#

  • Level: 4

  • Due: 2020-04-01

  • Completed: 2020-04-01

Warning

No description available

SUMMIT-2965: COMP: Camera Summit facility Ready for Use#

  • Level: 3

  • Due: 2020-04-01

  • Completed: 2020-04-01

Warning

No description available

COMC-060200-20750: ComCam arrives at summit#

  • Level: 4

  • Due: 2020-05-13

  • Completed: 2020-11-16

Warning

No description available

COMC-0620-0020: DMS Base Center Approved for System I&T#

  • Level: 3

  • Due: 2020-05-13

  • Completed: 2020-02-28

Warning

No description available

COMC-0620-2080: Summit Commissioning Cluster Test & Verficiation#

  • Level: 4

  • Due: 2020-05-14

  • Completion pending

Warning

No description available

COMC-0620-2090: Com. Cluster R8.1 Pre-Commissioning Acceptance#

  • Level: 3

  • Due: 2020-05-14

  • Completion pending

Warning

No description available

COMC-060200-20920: TMA Ready to Start Early System AI&T#

  • Level: 4

  • Due: 2020-06-10

  • Completed: 2020-06-10

Warning

No description available

SITCOM-89: ComCam + PathFinder installed on the cart Assembly at Level 3#

  • Level: 4

  • Due: 2020-06-17

  • Completed: 2021-08-31

Warning

No description available

NCSA-000: Start NCSA FY20 Services#

  • Level: 4

  • Due: 2020-07-30

  • Completed: 2020-07-30

Warning

No description available

SITCOM-88: Camera cart ready for ComCam#

  • Level: 4

  • Due: 2020-08-06

  • Completed: 2021-08-31

Warning

No description available

COMC-0620-2065: Base - Archive Network Functional 100 Gbps#

  • Level: 3

  • Due: 2020-12-29

  • Completion pending

Warning

No description available

SITCOM-91: Camera cart is fully assembled and tested#

  • Level: 4

  • Due: 2021-08-31

  • Completed: 2021-08-31

Warning

No description available

SUMMIT-3010: NEED: Access to TMA Refrigeration Lines#

  • Level: 3

  • Due: 2021-09-30

  • Completed: 2022-04-29

Warning

No description available

COMC-060200-20760: TCS w/WFS Available on Summit#

  • Level: 4

  • Due: 2021-10-29

  • Completed: 2023-05-31

Warning

No description available

SITCOM-90: ComCam + PF ready for on cart installation#

  • Level: 4

  • Due: 2021-12-30

  • Completed: 2021-12-30

Warning

No description available

SUMMIT-2955-500: Ready for ComCam - Refrigeration Tubing#

  • Level: Undefined

  • Due: 2022-02-07

  • Completed: 2021-11-30

Warning

No description available

SITCOM-95: Level 7th ready to receive the Camera cart Assembly#

  • Level: 4

  • Due: 2022-03-07

  • Completion pending

Warning

No description available

SITCOM-117: EAS fully integrated#

  • Level: 4

  • Due: 2022-03-31

  • Completion pending

Warning

No description available

COMC-060200-20965: Early System AI&T Complete#

  • Level: 4

  • Due: 2022-05-31

  • Completion pending

Warning

No description available

SITCOM-96: Computing Infrastructure in Place#

  • Level: 4

  • Due: 2022-05-31

  • Completion pending

Warning

No description available

SITCOM-112: Commissioning Compute Cluster fully configured and ready for general SIT-Com use#

  • Level: 4

  • Due: 2022-05-31

  • Completed: 2023-05-31

Warning

No description available

COMC-060200-20700: TMA Final Tests Start#

  • Level: 3

  • Due: 2022-06-06

  • Completed: 2024-03-01

Warning

No description available

COMC-0620-1100: Telescope Approved for System I&T#

  • Level: 3

  • Due: 2022-06-06

  • Completion pending

Warning

No description available

COMC-0620-0840: TMA Pre-Commissioning Acceptance#

  • Level: 3

  • Due: 2022-06-06

  • Completed: 2023-05-31

Warning

No description available

SITCOM-94: Level 3 System Spread integrations activities done#

  • Level: 4

  • Due: 2022-07-13

  • Completed: 2023-05-31

Warning

No description available

SUMMIT-2983: COMP: ComCam re-Verification Complete#

  • Level: 3

  • Due: 2022-07-13

  • Completed: 2020-11-15

Warning

No description available

SITCOM-100: M1M3 cell + Surrogate ready for installation on the TMA#

  • Level: 4

  • Due: 2023-04-17

  • Completed: 2023-06-15

Warning

No description available

SITCOM-108: Level-3 is ready for the M1M3 surrogate to glass transition#

  • Level: 4

  • Due: 2023-04-24

  • Completed: 2024-04-30

Warning

No description available

COMC-06020200-0800: Start Commissioning Readiness Review Preparations#

  • Level: 4

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-0620-2240: Base-Archive Network Full BW (100 Gbps)#

  • Level: 3

  • Due: 2023-05-01

  • Completed: 2023-05-01

Warning

No description available

COMC-NR-606290(12): Shipping Frame Ready for Camera#

  • Level: Undefined

  • Due: 2023-05-22

  • Completed: 2023-05-22

Warning

No description available

SITCOM-106: Initial integrated tests on TMA complete#

  • Level: 4

  • Due: 2023-06-02

  • Completed: 2023-05-31

Warning

No description available

SITCOM-98: T&S Milestone: TMA Contract Complete#

  • Level: 4

  • Due: 2023-06-02

  • Completed: 2023-05-31

Warning

No description available

SITCOM-92: Camera support asmy w/ComCam+PF+Int#1+CCW Installed on Telescope#

  • Level: 4

  • Due: 2023-07-03

  • Completed: 2022-12-01

Warning

No description available

SUMMIT-3013: NEED: Pathfinder in ComCam on TMA#

  • Level: 3

  • Due: 2023-07-03

  • Completed: 2023-06-30

Warning

No description available

COMC-060200-20800: Telescope 3-Mirror Testing Starts#

  • Level: Undefined

  • Due: 2023-07-05

  • Completion pending

Warning

No description available

SITCOM-99: M1M3 cell + surrogate installed and verified on the TMA#

  • Level: 4

  • Due: 2023-07-17

  • Completion pending

Warning

No description available

SITCOM-102: TMA safe for transition to M1M3 glass mirror#

  • Level: 4

  • Due: 2023-07-19

  • Completion pending

Warning

No description available

SITCOM-120: Calibration Pipeline fully implemented#

  • Level: 4

  • Due: 2023-08-18

  • Completion pending

Warning

No description available

SITCOM-118: AuxTel ready for on-sky characterisation#

  • Level: 4

  • Due: 2023-08-18

  • Completed: 2023-05-31

Warning

No description available

SITCOM-97: M1M3 cell+Surrogate Dynamic Testing on TMA done#

  • Level: 4

  • Due: 2023-08-30

  • Completion pending

Warning

No description available

SUMMIT-2990: COMP: Calibration Telescope Ready for Operations#

  • Level: 3

  • Due: 2023-08-31

  • Completion pending

Warning

No description available

COMC-NR-700000(023): Camera Ready for Shipping#

  • Level: Undefined

  • Due: 2023-09-27

  • Completion pending

Warning

No description available

COMC-NR-700600(100): Camera Support Hardware & Fixtures Ready for Shipping#

  • Level: Undefined

  • Due: 2023-09-28

  • Completion pending

Warning

No description available

SITCOM-103: M2 fit check successful#

  • Level: 4

  • Due: 2023-09-28

  • Completed: 2023-09-15

Warning

No description available

COMC-NR-700500(066): Camera Spares Ready for Shipping#

  • Level: Undefined

  • Due: 2023-10-06

  • Completed: 2024-04-18

Warning

No description available

SITCOM-105: ComCam + PF re-Installed on TMA#

  • Level: 4

  • Due: 2023-10-06

  • Completion pending

Warning

No description available

COMC-0620-0940: Mirror Integration Complete#

  • Level: 3

  • Due: 2023-10-19

  • Completion pending

Warning

No description available

SUMMIT-2975: LSSTCam Pre-Ship Acceptance#

  • Level: 3

  • Due: 2023-10-20

  • Completed: 2024-04-06

Warning

No description available

COMC-0620-6300: Camera Pre-Ship Acceptance#

  • Level: 3

  • Due: 2023-10-20

  • Completed: 2024-04-10

Warning

No description available

SUMMIT-2976: LSSTCam Received @ Summit#

  • Level: 2

  • Due: 2023-11-06

  • Completion pending

Warning

No description available

SUMMIT-3055: COMP: L1/L2 recevied at summit#

  • Level: 3

  • Due: 2023-11-06

  • Completion pending

Warning

No description available

COMC-0620-6500: Camera Received @ Summit#

  • Level: 2

  • Due: 2023-11-14

  • Completion pending

Warning

No description available

SUMMIT-3023: COMP: TMA Refrigeration Tests Complete#

  • Level: 3

  • Due: 2023-12-27

  • Completion pending

Warning

No description available

COMC-NR-606560(36): Filter Exchange Spares Ready for Shipping#

  • Level: Undefined

  • Due: 2024-04-01

  • Completed: 2024-04-01

Warning

No description available

SITCOM-127: M2 coating decision#

  • Level: 4

  • Due: 2024-04-25

  • Completed: 2023-10-01

Warning

No description available

SITCOM-104: M2 Glass installed on Cell#

  • Level: 4

  • Due: 2024-04-25

  • Completion pending

Warning

No description available

COMC-060200-20930: Camera Ready for Full System AI&T#

  • Level: 4

  • Due: 2024-04-30

  • Completion pending

Warning

No description available

SUMMIT-3056: COMP: Camera Reverification Complete#

  • Level: 3

  • Due: 2024-04-30

  • Completion pending

Warning

No description available

SITCOM-125: LSSTCam reverification complete#

  • Level: 4

  • Due: 2024-04-30

  • Completion pending

Warning

No description available

COMC-NR-720200(87): FES Support Hardware Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-01

  • Completion pending

Warning

No description available

COMC-NR-606050(99): DELETE - Integration Stand Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-01

  • Completion pending

Warning

No description available

COMC-NR-606530(30): Shutter #2 Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-01

  • Completion pending

Warning

No description available

COMC-NR-606590(45): Filters Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-01

  • Completion pending

Warning

No description available

COMC-NR-720100(082): Shutter Equipment Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-02

  • Completion pending

Warning

No description available

COMC-NR-720000(075): L1-L2 Container Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-07

  • Completion pending

Warning

No description available

COMC-NR-701100(110): Camera And Equipment at SFO#

  • Level: Undefined

  • Due: 2024-05-09

  • Completion pending

Warning

No description available

COMC-NR-606620(58): Cryo Cabinets Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-09

  • Completion pending

Warning

No description available

COMC-NR-701600(111): LSST Camera at Santiago Airport#

  • Level: Undefined

  • Due: 2024-05-13

  • Completion pending

Warning

No description available

SITCOM-109: M1M3 Mirror Coating completed#

  • Level: 4

  • Due: 2024-05-15

  • Completed: 2024-04-30

Warning

No description available

COMC-NR-606650(65): Chiller #1 Ready for Shipping#

  • Level: Undefined

  • Due: 2024-05-16

  • Completion pending

Warning

No description available

COMC-060200-20970: Ready to Start Full System AI&T#

  • Level: 4

  • Due: 2024-05-21

  • Completion pending

Warning

No description available

SITCOM-123: LSSTCam Installed on TMA#

  • Level: 4

  • Due: 2024-05-30

  • Completion pending

Warning

No description available

SITCOM-110: M1M3 installed on the TMA#

  • Level: 4

  • Due: 2024-06-12

  • Completion pending

Warning

No description available

SUMMIT-Oct24-150: START: Reinstall ComCam on TMA#

  • Level: Undefined

  • Due: 2024-07-01

  • Completion pending

Warning

No description available

SUMMIT-Oct24-160: ComCam Reinstalled on TMA#

  • Level: Undefined

  • Due: 2024-07-12

  • Completion pending

Warning

No description available

SITCOM-XXX: Camera Ready for Engineering Punchlist Resolution#

  • Level: 4

  • Due: 2024-07-17

  • Completion pending

Warning

No description available

New1135: LSSTCam Cold#

  • Level: 4

  • Due: 2024-07-17

  • Completion pending

Warning

No description available

COMC-060200-10210: Start of LSSTCam re-Verification#

  • Level: 4

  • Due: 2024-07-22

  • Completion pending

Warning

No description available

SITCOM-122: LSSTCam Ready for On Sky (First Photon)#

  • Level: 4

  • Due: 2024-07-24

  • Completion pending

Warning

No description available

SUMMIT-Oct24-170: START: ComCam First Photon#

  • Level: Undefined

  • Due: 2024-08-01

  • Completion pending

Warning

No description available

COMC-0642-9999: COMP: DMS- Integration Complete#

  • Level: 4

  • Due: 2024-08-07

  • Completion pending

Warning

No description available

New1110: Full focal plane readout complete#

  • Level: 4

  • Due: 2024-08-09

  • Completion pending

Warning

No description available

COMC-060200-20770: Global Interlock System Ready#

  • Level: 4

  • Due: 2024-08-20

  • Completion pending

Warning

No description available

SITCOM-116: Initial Optical testing on TMA complete#

  • Level: 4

  • Due: 2024-08-30

  • Completion pending

Warning

No description available

New1165: Telescope Aligned#

  • Level: 4

  • Due: 2024-08-30

  • Completion pending

Warning

No description available

SITCOM-111: In-Dome Calibration Hardware Ready for On-Sky Operations#

  • Level: 4

  • Due: 2024-09-03

  • Completion pending

Warning

No description available

SUMMIT-Oct24-180: COMP: ComCam on sky complete#

  • Level: Undefined

  • Due: 2024-10-25

  • Completion pending

Warning

No description available

COMC-060200-20960: DMS Ready for Full system AI&T#

  • Level: 4

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

SITCOM-119: Ops rehearsal for data release processing #3#

  • Level: 4

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

SITCOM-114: All Data Management 1a Priority Requirements Functionally Demonstrated#

  • Level: 4

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

SITCOM-121: System First Light with LSSTCam#

  • Level: 4

  • Due: 2024-11-01

  • Completion pending

Warning

No description available

COMC-060204-1000: Operational lookup tables for AOS complete#

  • Level: 4

  • Due: 2024-11-22

  • Completion pending

Warning

No description available

SITCOM-126: Engineering tests with LSSTCam complete#

  • Level: 4

  • Due: 2024-12-06

  • Completion pending

Warning

No description available

COMC-0620-9000: Archive Center Ready for System I&T at SLAC#

  • Level: 3

  • Due: 2024-12-09

  • Completion pending

Warning

No description available

SUMMIT-3082: COMP: LSSTCam-Tel Integration Complete#

  • Level: 3

  • Due: 2024-12-09

  • Completion pending

Warning

No description available

COMC-060200-10300: Start of On-Sky & Calibration Data with LSSTCam#

  • Level: 4

  • Due: 2025-01-09

  • Completion pending

Warning

No description available

COMC-0653-1000: COMP: Science Validation 1 Data Release Complete#

  • Level: 3

  • Due: 2025-02-27

  • Completion pending

Warning

No description available

COMC-0654-1000: COMP: Calibration Products Production Verified#

  • Level: 3

  • Due: 2025-02-27

  • Completion pending

Warning

No description available

COMC-0654-1070: COMP: Data Release Production Verified#

  • Level: 3

  • Due: 2025-02-27

  • Completion pending

Warning

No description available

COMC-0654-0430: COMP: Science Validation Surveys Complete#

  • Level: 3

  • Due: 2025-02-27

  • Completion pending

Warning

No description available

SITCOM-129: Science Verification Complete#

  • Level: 4

  • Due: 2025-03-06

  • Completion pending

Warning

No description available

SITCOM-130: Operation Readiness Review Complete#

  • Level: 4

  • Due: 2025-03-06

  • Completion pending

Warning

No description available

COMC-060200-10500: Start of Science Verification Science Validations#

  • Level: 4

  • Due: 2025-03-31

  • Completion pending

Warning

No description available

SUMMIT-3077: COMP: LSSTCam Ready for Bulk Data Production#

  • Level: 3

  • Due: 2025-03-31

  • Completion pending

Warning

No description available

Bibliography#
